Underground Power

Underground Power
  • Open date

    30 September 2024

Last update date: 25 February 2025

The City of Stirling has partnered with Western Power to work together towards converting overhead distribution powerlines to underground power, to deliver reliable and safe power, while improving street appearance and opportunities for increased uptake of solar and other technologies.

Underground power offers improved reliability and safety, while increasing power supply capacity, improving property values, street appeal and allowing the tree canopy to flourish.

The underground power project will be carried out in stages. Before each stage commences, residents within the project boundary will receive a notification outlining what will be done and how it may impact you.

The process of transforming a suburb to underground power means that some things are going down - poles and lines - whilst some new things are going up - primary equipment sites or those large boxes on the side of the road or back of a park. A community forum for the whole suburb called 'Watts Up Is Going Down' will help answer people's questions about who is doing what and when.

The cost of undergrounding power is shared between the State Government, Western Power, local government, and property owners, with payment facilitated through the City of Stirling. The City will be responsible for invoicing residents for the installation costs. This cost and partnership model addresses the need to renew ageing electricity infrastructure, while acknowledging the shared benefits of this project.

Project timeline

Osborne Park

TBC

Doubleview

February 2025 – June 2026

North Perth/Mount Hawthorn

Early 2025 - late 2026

Scarborough

October 2021 – October 2022

Trigg

February 2020 – March 2021 (round 6)

Menora

February 2019 – February 2020 (round 6)

Coolbinia

July 2013 – January 2015 (round 5)

Churchlands / Wembley

September 2006 – September 2008 (round 3)

View more

When is underground power coming to my area?

To find out if your suburb is listed for underground power, please visit Western Power. Please note that Western Power determines the order of these projects based on the age of the assets in that area and therefore the need to underground them.

Note: This is the latest information provided by Western Power and will be updated on a regular basis as new information becomes available (last updated April 2024).

Doubleview

  • Area on map 7
  • Scheduled start date TBC
  • Scheduled completion date TBC
  • Project type Network Renewal Undergrounding Program Pilot (NRUPP)
  • Project map Download map.

Osborne Park

  • Area on map 32
  • Scheduled start date TBC
  • Scheduled completion date TBC
  • Project type Targeted Underground Power Program (TUPP)
  • Project map Download map.

North Perth/Mount Hawthorn

  • Area on map 343
  • Scheduled start date Q2 2025
  • Scheduled completion date Q3 2026
  • Project type Network Renewal Undergrounding Program Pilot (NRUPP)
  • Project map Download map.

Tuart Hill

  • Area on map 31
  • Status Construction commencement (TBC).

Stirling/Tuart Hill

  • Area on map 28
  • Status Construction commencement estimated 2026.

Balcatta

  • Area on map 355A and 355B
  • Status Construction commencement (TBC).

Yokine

  • Area on map 85
  • Status Construction commencement (TBC).

Inglewood

  • Area on map 40
  • Status Construction commencement (TBC).

Doubleview FAQs

Western Power targets areas where the overhead network is due, or will soon be due, for replacement. Once Western Power has identified a project area, it approaches the relevant local government with an offer to convert that area to underground power. Western Power makes offers to local governments in priority order, based on the need to upgrade the network.

The cost for different suburbs and projects will vary depending on the unique site conditions, constraints imposed by ground conditions, and the number of properties within the nominated precinct.

Western Power conduct an open tender process for each project and select the best contractor based on their selection model. The City has no involvement in this process. If you wish to discuss this matter further, please contact Western Power, please click here to be taken to their Underground Power website.

Under the TUPP, the costs of the program are shared between Western Power, Local Government and the State Government with total costs determined by Western Power. The State Government’s contribution is tiered based on socio-economic factors.

The City has adopted a ‘user pays’ model to recoup its contribution from properties directly benefitting. Residents are required to pay a proportion of the network cost, regardless of whether the resident’s service connection is undergrounded or not. Residents without an underground connection will also need to pay a connection cost.

The City has used a dollar per kilo-volt-ampere (KVA) allocation methodology for the financial model to determine the Network Charge to Property Owners.

The network has been designed to meet the expected energy requirements for the area and this is achieved by allocating a KVA to each property type. The total KVA’s are added up together and then divided by the total project network cost to get a dollar per KVA. The dollar per KVA is then multiplied against an assigned expected KVA for that property which results in the total network fee for that property.

A connection charge is then calculated based on the connection type for each property and then added to the network charge to arrive at the full project cost required to be paid by the property owner.

SUPP projects are based on a user-pays principle, where those benefitting are those required to pay a contribution. The benefits of the program are received by the State Government agencies (through upgrade of their infrastructure) and the ratepayers (through improved reliability, efficiency of services and improved property values).

Local governments are not the asset owners, do not receive any direct benefits, and therefore do not contribute to the cost of the project (outside of contributions required for City-owned properties). Funding such activities out of operational budgets would place upward pressure on rates paid by all property owners in The City.

Western Power is contributing 88% of the network cost. Ratepayers are required to contribute the remaining 12%. This equates to a network charge of $2,078 per residential property. Businesses are charged a variable network charge based on the demand they place on the network.

Pensioners and seniors who have the following concession cards may be eligible for underground power rebates under the Rates and Charges (Rebates and Deferments) Act 1992:

  • Pensioner Concession Card (up to 50% discount)
  • State Concession Card (up to 50% discount)
  • WA Seniors Card with a Commonwealth Seniors Health Card (up to 50% discount)
  • WA Seniors Card only (up to 25% discount, to a maximum of $100).

Holders of the above cards (except those who only have a WA Seniors Card) may also be eligible to defer paying their underground power charge. This means the charge remains as a debt on the property until the property is sold. It does not incur interest charges.

You can also access the Apply for a pensioners or seniors rebate web page or the Pensioners and Seniors Concessions Scheme fact sheet for more information.

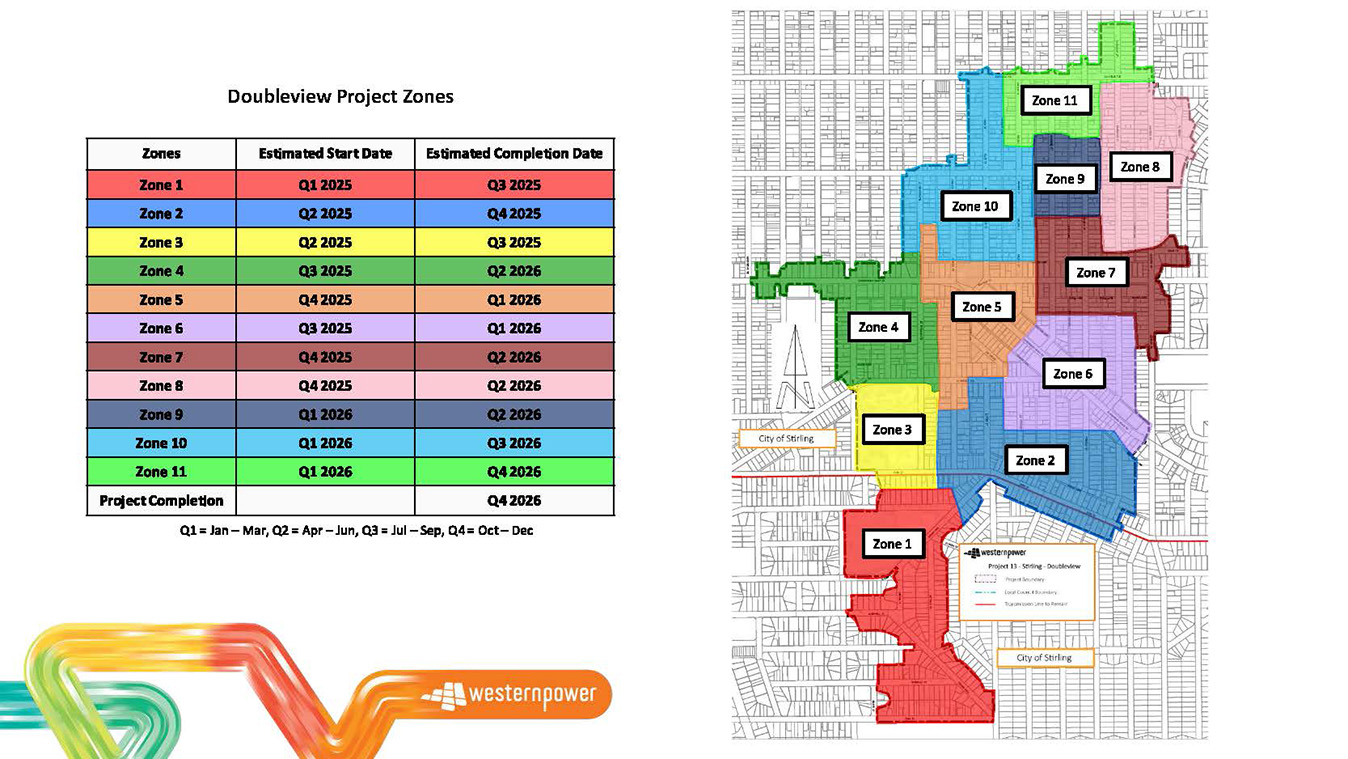

Please see below Doubleview Project Zones which includes estimated start and completion dates.


Yes. Most of the cost of undergrounding power is laying new underground cables in the street and installing new street lighting. Those properties which have an existing pole to pillar connection e.g. an underground cable within their property from an overhead street network via green dome either within their own property or an adjoining property, will be required to contribute towards the overall cost of the project in the form of network cost.

Any property, where a person resides who is registered as having a medical condition which necessitates constant power supply, will be given special consideration when the changeover is programmed. The affected resident, or their carer, needs to contact Western Power or the contractor so that arrangements can be made to carry out the changeover without risk to the affected person’s health or welfare.

How does underground power work?

The installation of primary equipment is vital in delivering underground power. It includes equipment such as ground-mounted transformers and switchgear units to distribute electricity through the underground network. The equipment is typically housed in green cabinets as shown in the image below.

The location of where primary equipment is installed is assessed based on technical needs, safety, and social impacts. Whenever possible, the equipment is placed in public open spaces, road reserves, and verges.

The below video explains the underground power process.

Underground power

FAQs

The cost of undergrounding power is shared between the State Government, Western Power, local government, and property owners, with payment facilitated through the relevant Local Government Authority.

This cost and partnership model addresses the need to renew ageing electricity infrastructure, while acknowledging the shared benefits of this project.

  • Western Power funds part of the network services charge (or network infrastructure costs) to remove power poles, placing overhead distribution cables below ground, and installing new streetlights. Cost is subjected to project area
  • Ratepayers are charged for the remining balance of the network services charge (or network infrastructure costs), plus a connection fee for the underground cable to be joined from your property. The connection point or green dome (pillar) is installed on your property boundary share between your neighbour and joined to your home.

Ratepayers will pay one single consumer mains charge, which is the combined total of the network charge for their area and applicable connection fee for their property.

Yes, the City will allow those who are unable to make a lump sum payment the opportunity to pay in instalments over six years.

Payment options are outlined in the Notice. If you are unable to meet these options, please contact the City to discuss the matter further.

Payments can be made online or by calling the City on (08) 9205 8555.

Ratepayers who are eligible pensioners and seniors will receive a State Government rebate.

Eligibility provisions for any person seeking to register with the City for underground power concessions are:

  • Be the owner and occupier of property as of 1 July each year
  • Be classified as a Pensioner or Senior.

Pensioner

  • You receive the pension and are the holder of a Pensioner Concession Card or State Concession Card
  • Pensioner concessions are entitled up to 50 per cent of the underground power and are subject to the maximum amount.

Senior

  • You hold a Seniors Card issued by the Office of Seniors Interests and a Commonwealth Seniors Health Card
  • Senior concessions are entitled up to 25 per cent and are subject to the maximum amount, deferment is not available.

The owner of the property as of the due date of the levy being charged is responsible for full payment of the invoice. Underground power charges are not apportioned between the buyer and seller and the seller is required to pay the balance of charges at settlement.

If you, as the seller, have already paid the lump sum amount there will be no adjustment as part of the property settlement

If you, as the seller, have decided to participate in the instalment option, the City will calculate the remainder of the scheme costs to the end of the term and provide this information to your settlement agent for payment at settlement. You will be responsible for the full costs and they will not be adjusted between you and the buyer.

The model considers how many properties are connected to each main meter and then splits that single main meter connection charge between the number of units that are fed from that main meter. For example, if there are 10 units connected to a single main meter then the single connection charge will be divided by 10. If a person owns more than one of those units then they will be required to pay the percentage based on that number, e.g., if they owned 5 out of the 10 then that property owner would have to pay 50% of that single connection charge.

Watts Up is Going Down Information Session

We know that when we talk to locals about their priorities for their neighbourhood, underground power is always in the top couple of answers. Undergrounding those poles and wires doesn't just enable more trees to be planted along our streets, but it also better protects that infrastructure from storm damage.

As part of the Western Power program to deliver underground power across the City, we will partner with Western Power to hold a community forum in each underground power project area at the start of each project. These 'Watts Up is Going Down' sessions will help answer some frequently asked questions like:

  • Who exactly is delivering the project?
  • When will underground power come to my suburb?
  • How does the payment work?
  • Which agency can answer which questions?
  • How will this appear on my rates notice?

Experts from both Western Power and the City of Stirling will attend these community meetings and be able to answer your questions in person.

Types and placement of primary equipment

Types and placement of primary equipment

When moving power lines underground and removing poles, several essential equipment types are used:

  • Transformers: These convert higher voltages to a safe level for homes and local businesses.
  • High voltage switchgear: It safeguards system integrity and enables efficient maintenance without prolonged outages.
  • Low voltage kiosks: These distribute power to multiple premises and facilitate rapid fault recovery.

Residents visually impacted by proposed Primary Equipment sites will be sent a letter.

For any information relating to underground power charges, please contact the City of Stirling at (08) 9205 8555 or email undergroundpower@stirling.wa.gov.au

For any technical queries relating to the Western Power underground infrastructure or its placement, please contact Western Power on 13 10 87.

Share this page
